IREN March 2025 Monthly Update

2025-04-04T11:09:44Z

SYDNEY, April 04, 2025 (GLOBE NEWSWIRE) -- IREN Limited (NASDAQ: IREN) (together with its subsidiaries, “IREN” or “the Company”), today published its monthly update for March 2025.

March Highlights

  • Operating data center capacity increased to 660MW
  • Bitcoin mining capacity now 37 EH/s, up from 31 EH/s
  • On track for 50 EH/s in H1 2025
  • Pausing mining expansion at 52 EH/s for AI / HPC
  • New 600MW grid connection agreement signed
  • 2.75GW now secured for data centers in West Texas
  • Progressing debt financing workstreams

March 2025 Highlights

Key MetricsMar 25Feb 25Jan 25
Bitcoin Mining
Average operating hashrate30.3 EH/s28.7 EH/s29.0 EH/s
Bitcoin mined3533 BTC459 BTC521 BTC
Revenue (per Bitcoin)$85,012 $95,570 $99,789
Electricity cost (per Bitcoin)1($20,460) ($28,341) ($24,683)
Revenue$45.3m$43.9m$52.0m
Electricity costs1($10.9m)($13.0m)($12.9m)
Hardware profit2$34.4m$30.9m$39.2m
Hardware profit margin476% 70% 75%
AI Cloud Services
Revenue$1.6m$1.2m$0.8m
Electricity costs1($0.05m)($0.04m)($0.04m)
Hardware profit2$1.5m$1.1m$0.8m
Hardware profit margin497% 96% 96%

Management Commentary

“As we approach our 50 EH/s milestone, we’re pausing further Bitcoin mining expansion and narrowing our focus on scaling our AI Cloud Services and AI Data Center businesses,” said Daniel Roberts, IREN Co-Founder and Co-CEO.

“This month, we secured an additional 600MW of grid-connected capacity, reflecting years of groundwork and bringing our total secured power capacity in West Texas to 2.75GW. This strengthens our position as a leading data center developer and sets us apart from speculative pipelines. We’re also closely monitoring recent tariff changes and their potential impact on our supply chains.”

“Our capital strategy for AI opportunities prioritizes customer prepayments and a range of debt financing solutions, with the at-the-market facility serving as a strategic backstop to enhance execution certainty and support ongoing commercial engagement across our AI platform.”

Technical Commentary

Bitcoin Mining

  • Maintaining strong and resilient margins - lower Bitcoin prices in March offset by lower electricity costs, underpinned by our energy market intelligence and algorithms (2.5 c/kWh Childress power price driving ~$20k electricity cost per Bitcoin)1
  • 37 EH/s installed after month-end, on track for 50 EH/s in H1 2025 - expected to generate annualized illustrative net cashflows of $528m at 50 EH/s5

AI Cloud Services

  • Revenue grew 33% month-on-month, driven by new customer onboarding, with annualized run-rate revenue now $26 million6
  • GPU financing workstreams progressing to support potential cloud expansion at IREN’s Prince George data center, in response to growing customer demand for air-cooled Blackwell B200 clusters

AI Data Centers

  • Customer engagement continues for Horizon 1 (50MW IT Load), IREN’s liquid-cooled AI data center at Childress
  • Procurement is underway for long-lead equipment to enable rapid expansion of liquid-cooled capacity beyond the initial 50MW deployment
  • A range of financing options under evaluation, including customer prepayments, corporate and project-level debt, convertible notes, and asset-backed financing and leasing

Events

  • NVIDIA GTC
    IREN presentation replay available here
  • Canaccord Digital Assets Symposium
    Apr 16, 2025
  • Jefferies Power x Coin Conference
    Apr 16, 2025

Kent Draper, CCO, Presenting at NVIDIA GTC, San Jose (Mar 2025)

Kent Draper, CCO, Presenting at NVIDIA GTC, San Jose (Mar 2025)

Project Update

Childress (750MW)

  • Phase 4 (150MW) energized, with site operating data centers increased to 500MW
  • Phase 5 (150MW) new data centers on track for energization in coming months
  • Horizon 1 (50MW IT load) general site works underway for H2 2025 commissioning

Sweetwater 1 (1.4GW)

  • General site-works underway
  • Prioritizing whole-of-site, single tenant opportunities which continue to progress
  • Energization April 2026

Sweetwater 2 (600MW)

  • 600MW grid-connection agreement signed
  • Design work underway on a direct fiber loop connecting Sweetwater 1 & 2 to create 2GW Sweetwater data center hub
  • Energization late 2027

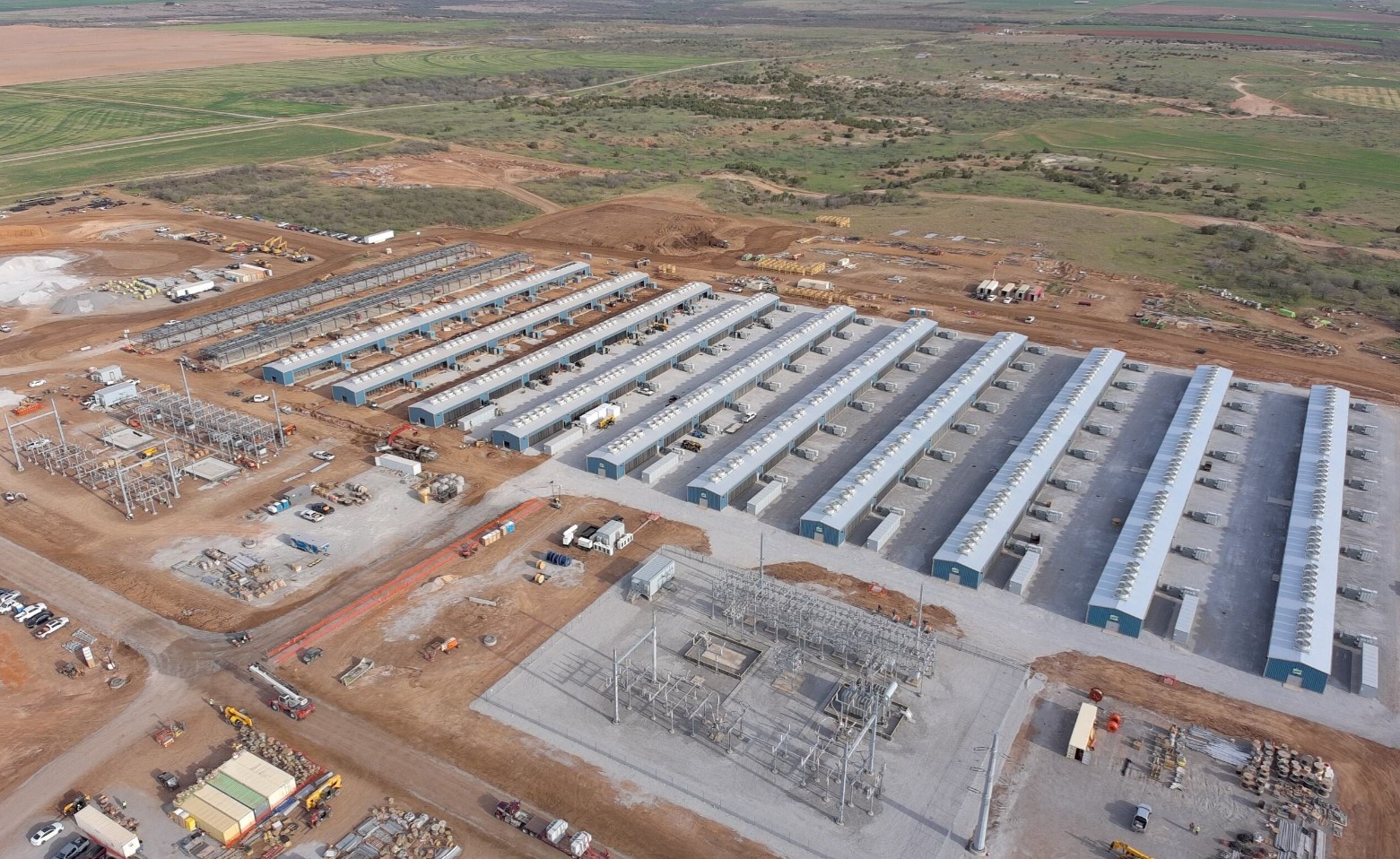

Childress Phase 4 & 5 Construction (Mar 2025)

Childress Phase 4 & 5 Construction (Mar 2025)

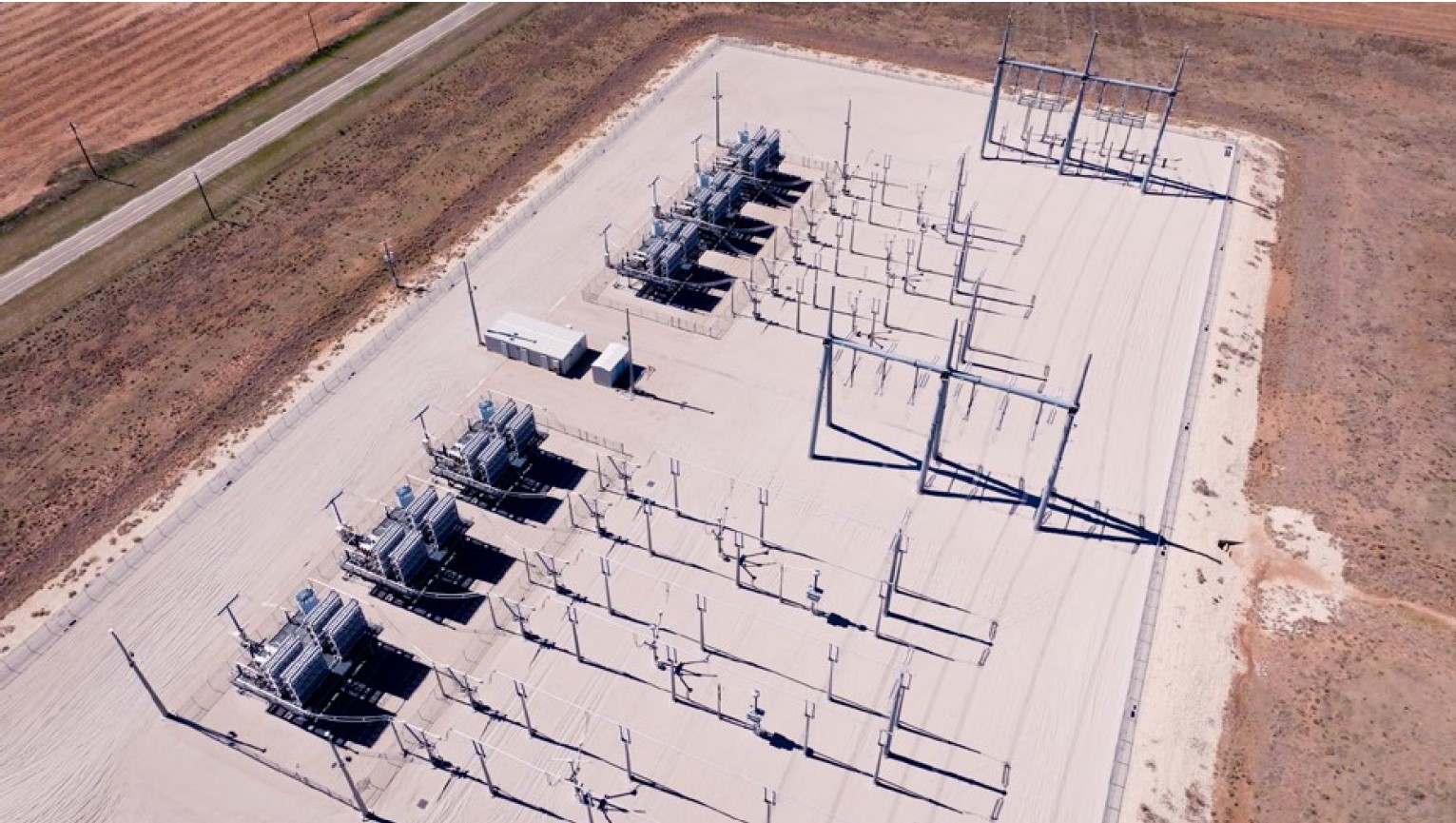

Utility Switchyard at Sweetwater 2 (Mar 2025)

Utility Switchyard at Sweetwater 2 (Mar 2025)

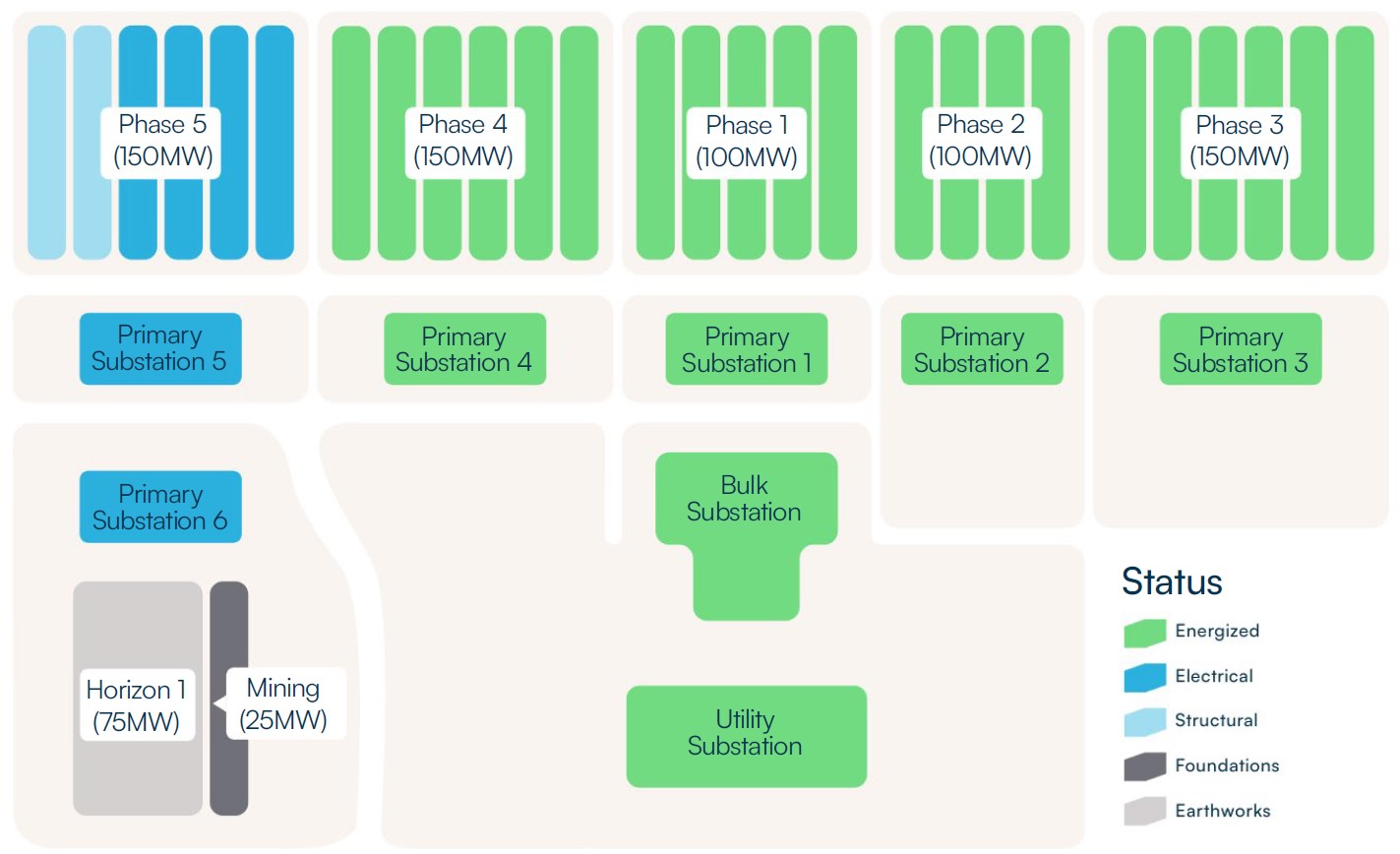

Childress Project Status

Childress Project Status

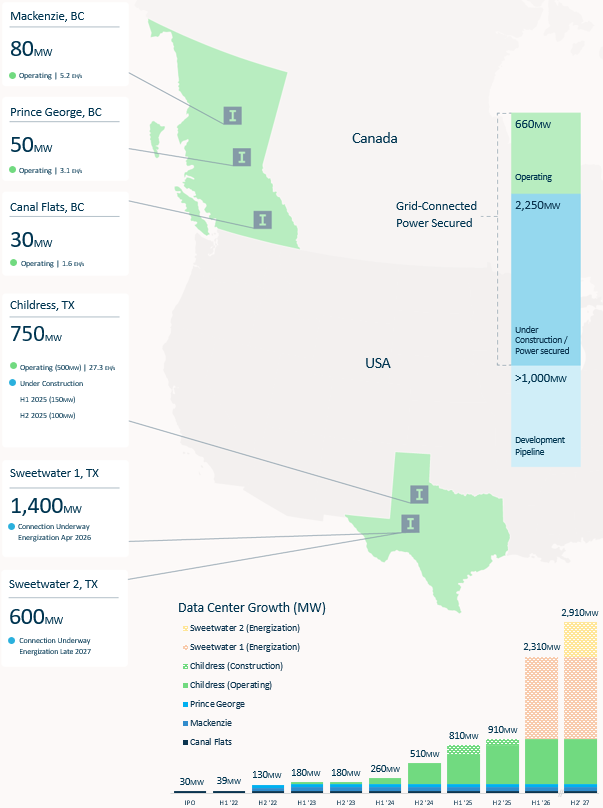

Site Overview

Site Overview

Assumptions and Notes

  1. Electricity costs are presented on a net basis and calculated as IFRS electricity charges, ERS revenue (included in other income) and ERS fees (included in other operating expenses). Figures are based on current internal estimates and exclude REC purchases.
  2. Hardware profit is calculated as revenue less electricity costs. Hardware profit is a non-IFRS financial measure and is provided in addition to, and not as a substitute for, measures of financial performance prepared in accordance with IFRS. Refer to the Forward-Looking Statements disclaimer.
  3. Bitcoin and Bitcoin mined in this investor update are presented in accordance with our revenue recognition policy which is determined on a Bitcoin received basis (post deduction of mining pool fees).
  4. Hardware profit margin for Bitcoin Mining and AI Cloud Services is calculated as revenue less electricity costs, divided by revenue (for each respective revenue stream) and excludes all other costs.
  5. Illustrative Net Cashflow = illustrative mining revenue less assumed net electricity costs, overheads and REC costs, and does not include working capital movements. Source: CoinWarz Bitcoin Mining Calculator. Illustrative calculations and inputs assume hardware operates at 100% uptime, 815 EH/s global hashrate, $0.035/kWh electricity costs, 3.125 BTC block reward, 0.1 BTC transaction fees and 0.13% pool fees, 765MW (power consumption), $104m (overheads), $16m (REC costs), and $85k Bitcoin price. Illustrative Net Cashflow is for illustrative purposes only and should not be considered projections of IREN’s operating performance. Inputs are based on assumptions, including historical information, which are likely to be different in the future and users should input their own assumptions. There is no assurance that any illustrative outputs will be achieved within the timeframes presented or at all, or that mining hardware will operate at 100% uptime. The above should be read strictly in conjunction with the forward-looking statements disclaimer in this press release.
  6. AI Cloud Services annualized run-rate revenue for utilized GPUs as of March 31, 2025.
